Prescott Park Master Plan Implementation Committee

Mailing List

Content

Prescott Park Master Plan

Subscribe

* indicates required

Phase 1A Plan July 2022 (see full presentation link in the column at right)

The City Council voted on July 11, 2022 to approve the recommendation of the Prescott Park Master Plan Implementation Committee to move forward with the following Phase 1A work:

1. Remove asphalt pavement on Water Street.

2. Trench and install new sewer, water, gas, and storm water infrastructure under Water Street. Connect stormwater through to the Piscataqua and make it operational.

3. Demolish the “Garage” and “Lean-To” structures back fill the existing foundations and relocate their functions to the Lacava Wharf Barn.  This will allow for an area to house trailers for PPAF in the event that Shaw is not available for occupancy.

4. Lift and relocate the Shaw building onto its new foundation. Excavate for and place new foundations for the Shaw building.

5. A long sloping lawn (approx. +3’ high will exist along the entire length of the Phase 1A work line, to accommodate the new grade change, and until the remaining phases are implemented.

6. Backfill Water Street to a new elevation matching the grade at Liberty Park.

7. Resurface Water Street and install final landscaping surfaces within the limit of work and “feather” them into existing surfaces that are remaining for future phases

Ground Site Testing on November 8, 2021

The City of Portsmouth Department of Public Works completed four five-foot, by five-foot, by five-foot “test pits” at Prescott Park on Monday, November 8, 2021, as part of the investigatory engineering required to implement the Prescott Park Master Plan. The work will be conducted in conjunction with a soils scientist designated by the project consultant Weston and Sampson Engineers and an archaeologist. For the results of those tests, see the documents in the sidebar at right.

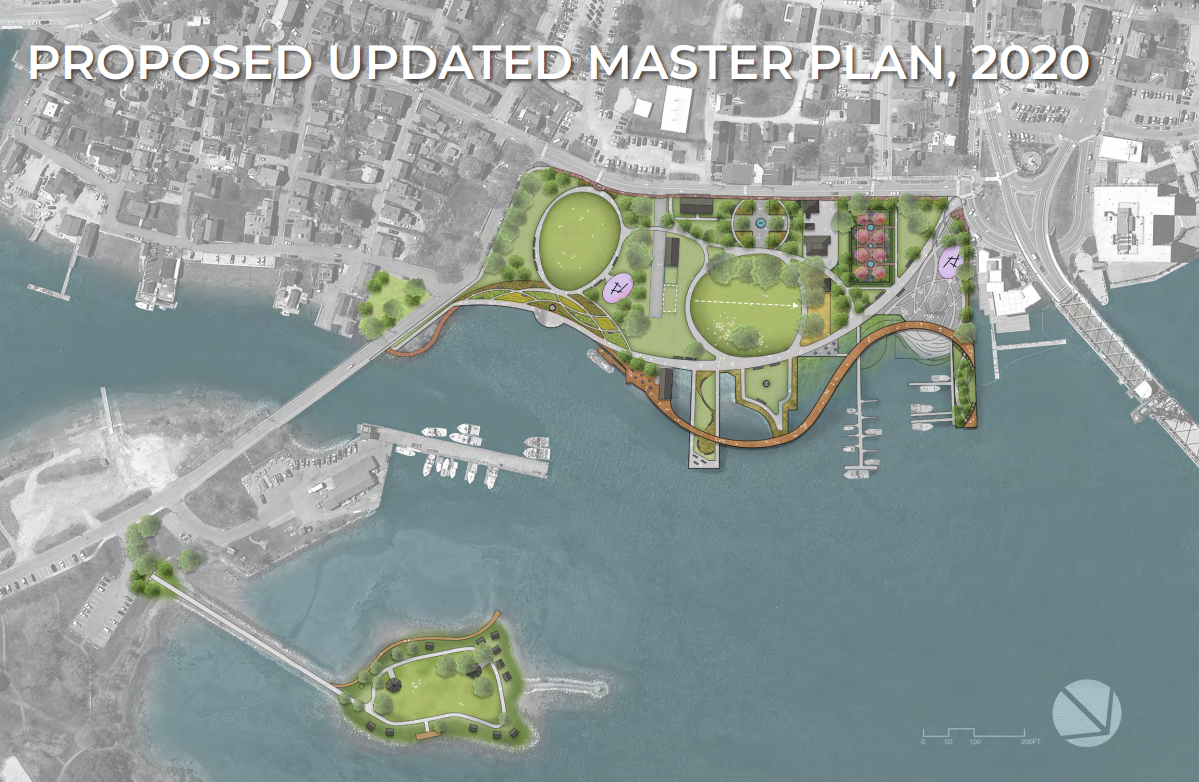

Since the completion of the Prescott Park Master Plan and the Prescott Park Policy Advisory Committee, the City has engaged Weston & Sampson to assist it with the enabling engineering to begin implementation of the Plan.  This work is funded via Capital Improvement Program.  A topographical survey of the Park, along with a survey of the underground utilities and an assessment of the historic buildings has been completed  In addition, the consultants have completed tidal inundation study to establish resiliency goals for the upgraded park.

On May 4, 2020, Mayor Becksted appointed a Blue Ribbon Committee to oversee this work and recommend future phasing and design details for City Council consideration.

An informational meeting on the Proposed Phase 1 Implementation was held on September 15th.  Presentation materials used in the meeting are available here

The final virtual public meeting took place on October 29th at 6:30 to review what the first Phase of Master Plan Implementation may entail.  Presentation materials used in the meeting are available here

The Committee presented its proposed Phase 1 Implementation Plan to the Historic District Commission on December 9th in work session.

Committee Members

Content
Name Address Appointment Date

Genevieve Aichele

47 Orchard St. 5/4/2020
Alan Gordon 620 Woodbury Ave. 5/4/2020

Vacant, Council Rep.

Robin Lurie-Meyerkopf 53 Whidden St. 5/4/2020
Beth Margeson 24 Marcy St. 5/4/2020
Thomas Watson,
Trustee Trust Fund, Chair
200 New Castle Ave. 5/4/2020

Comments to the Committee

If you would like to provide input electronically to members of the Committee, please use this web comment form below.
